Electricity system optimisation

Preparation

Now that we can simulate an electricity system we can combine this information with the costs and impact over its lifetime, and those of many other system configurations, in order to select the optimum for our chosen application and criteria. This will allow us to choose the most suitable combination of generation and storage technologies to meet our needs most cost effectively, for example.

Before we can do this we need to provide more information about the the impacts of the installed system, and the conditions that we define to be the optimum for our scenario.

Finance inputs

Financial information is often the key decision metric for designing and implementing a system: renewable energy systems can provide a number of co-benefits, but often ultimately need to make financial sense in order to be selected for deployment. This could be in terms of providing electricity at a given price, for example lower than the incumbent or some alternative option, or ensuring that the total cost of a system does not exceed a certain budget.

The inputs for the financial impact of the system are included in the Finance inputs file, which is located in the Impact folder of your location folder. Let’s take a look at the inputs for the Bahraich case study:

0 1 2
0 Discount rate 0.100 fraction
1 PV cost 500.000 $/kWp
2 PV O&M 5.000 $/kWp p.a.
3 PV cost decrease 5.000 % p.a.
4 Storage cost 400.000 $/kWh
5 Storage O&M 10.000 $/kWh p.a.
6 Storage cost decrease 5.000 % p.a.
7 Diesel generator cost 200.000 $/kW
8 Diesel generator cost decrease 0.000 % p.a.
9 Diesel fuel cost 0.900 $/litre
10 Diesel fuel cost decrease -1.000 % p.a.
11 Diesel O&M 20.000 $/kW p.a.
12 BOS cost 200.000 $/kW
13 BOS cost decrease 2.000 % p.a.
14 PV installation cost 100.000 $/kW
15 PV installation cost decrease 0.000 % p.a.
16 Diesel installation cost 50.000 $/kW
17 Diesel installation cost decrease 0.000 % p.a.
18 Connection cost 100.000 $/household
19 Kerosene cost 0.008 $/hour
20 Grid cost 0.010 $/kWh
21 Grid extension cost 5000.000 $/km
22 Grid infrastructure cost 2000.000 $
23 Inverter cost 200.000 $/kW
24 Inverter cost decrease 2.000 % p.a.
25 Inverter lifetime 4.000 years
26 Inverter size increment 1.000 kW
27 Misc. costs 0.000 $/kW
28 General O&M 500.000 $ p.a.

These variables describe the costs of the various elements of the energy system and will be dependent on the specifics of your location; although this is true for all of the input files, the costs are likely to vary significantly between locations and can also have a relatively large impact on the results of your optimisation. These data can be difficult to assign specific values (for example if different suppliers have different costs for a given component, or if lower costs are available for purchasing larger quantities) so the general ethos should be to use a value reflective of what is available for your location. Take care to notice the units of each variable as using an input in the wrong units would affect the costs significantly. The table below describes in more detail what each variable means:

Variable Explanation
Discount rate The discount rate or cost of finance, expressed as a fraction
PV cost Cost of PV modules in $/kWp
PV O&M The annual cost of maintaining PV modules in $/kWp
PV cost decrease The annual cost decrease of PV modules in %
Storage cost The cost of storage in $/kWh
Storage O&M The annual cost of maintaining storage in $/kWh
Storage cost decrease The annual cost decrease of storage in %
Diesel generator cost Cost of a diesel generator in $/kW
Diesel generator cost decrease The annual cost decrease of a diesel generator in %
Diesel fuel cost Cost of diesel fuel in $/litre
Diesel fuel cost decrease The annual cost decrease of diesel fuel in %
Diesel O&M The annual cost of maintaining the diesel generator in $/kWh
BOS cost Cost of balance of systems (BOS) components for PV in $/kWp
BOS cost decrease The annual cost decrease of BOS components in %
PV installation cost Cost of installing PV modules in $/kWp
PV installation cost decrease The annual cost decrease of installing PV modules in %
Diesel installation cost Cost of installing diesel generators in $/kW
Diesel installation cost decrea se The annual cost decrease of installing diesel generators in %
Connection cost The cost of connecting a household to the system in $
Kerosene cost The cost of using a kerosene lamp for one hour in $
Grid cost The cost of grid electricity in $/kWh
Grid extension cost The cost of extending the grid by 1 km in $
Grid infrastructure cost The cost of transformers (etc.) to connect the system to the grid in $
Inverter cost Cost of an inverter in $/kW
Inverter cost decrease The annual cost decrease of an inverter in %
Inverter lifetime The lifetime of an inverter in years
Inverter size increment The variety of available sizes of inverters in kW
Misc. costs General miscellaneous capacity-dependent costs for the system in $/kW
General O&M General miscellaneous annual costs for the system in $ per year

The first variable, Discount rate, describes the cost of financing used when considering the value of money over time. This is input here as a fraction, 0.1, corresponding to a discount rate of 10%. The cost of financing can vary significantly between countries and projects depending on many factors, such as the risk associated with the project, and can affect the cost effectiveness of different technologies: broadly speaking, a high discount rate will discourage large initial investment (for example in solar and storage capacity) and favour repeated expenditure over time (for example on diesel fuel).

The costs of solar generation, diesel and storage technologies are treated similarly. Each has a cost associated with purchasing the equipment and maintaining it dependent on the total capacity installed, and an annual cost decrease representing how costs of technology can change over time (we define these variables as a decrease, so a positive value represents costs falling over time whilst a negative value represents them increasing). The diesel generator has additional variables associated with the cost of fuel, solar generation has those for balance of system components such as frames and wiring, and both have costs of initially installing the generation capacity; these are all treated in a similar way.

Two variables relate directly to households in the system. The first is Connection cost, which represents the cost of connecting a household to the system; this could include wiring, electricity meters, installation costs, or any others related to providing a household with a connection. The second is Kerosene cost, which is the cost that a household incurs for using one kerosene lamp for one hour. This would mainly be comprised of the cost of kerosene fuel, but could also include a contribution to the cost of the lamp itself although this will likely be negligible. This variable is used to calculate the spending on kerosene by the community when electricity is unavailable.

The cost of electricity from the grid used by the system is assigned in Grid cost. Additional costs associated with the national grid are Grid extension cost, which represents the cost of extending the network to the community being investigated if it is not currently present there, and Grid infrastructure cost, which is the cost of the transformers and other equipment used to convert power from the grid for use in the local distribution network. At present Grid extension cost is not used in the financial calculations, but could be used in the future to calculate the breakeven distance at which an off-grid system is more cost effective than extending the national network.

Variables about the inverter used in the system are also included here, with the cost and cost decrease acting similarly to those for generation and storage capacities. In addition the lifetime of the inverter, in years, is included to govern the points in the simulation at which the inverter must be replaced and a new one is purchased; this is included here as depending on the length of a simulation period and its point in the overall lifetime of the system it may necessitate several, or no, replacements. The Inverter size increment variable describes the capacity of inverters that are available to be used: for example if this variable is set to 3 kW then the system can used an inverter with a 3 kW, 6 kW, or 9 kW (and so on) capacity, with the inverter being oversized as necessary.

Finally, Misc. costs and General O&M can be used to include any additional miscellaneous costs that are not captured in the other variables and that are dependent on either the capacity of the system or are annually recurring, respectively.

If you are not using certain technologies in your investigation then it is not necessary to provide values for all of the variables included here. For example, if you are evaluating a solar and battery storage system operating far from the national grid network, you do not need to input values relating to diesel generators, fuel, or the cost of electricity from the national grid. In this case it is best to leave the default values in place or set them to zero, rather than delete them, to ensure that you do not introduce any issues in the way that CLOVER reads the CSV file.

These variables are designed to enumerate the financial inputs into separate and easy-to-update categories, but some can be combined if necessary if their units allows. For example, if a supplier is offering that a complete solar system can be installed for a given price, this can be captured in PV cost on its own rather than also trying to assign values to BOS cost and PV installation cost (which here could be set to zero as they are included in PV cost). Likewise if the system is maintained by a single operator, and is not dependent on the capacity that has been installed, it may make more sense to include their salary in General O&M and set PV O&M (etc.) to be zero; this method would not consider other capacity-dependent costs however, such as minor replacement parts.

Complete the Finance inputs CSV file with the financial information for your investigation.

Environmental inputs

CLOVER allows users to analyse the environmental impact of their systems to explore the potential benefits of low-carbon energy technologies. At present these are considered using the greenhouse gas (GHG) emissions of the various technologies both in terms of embedded GHGs from their manufacture and the impact over their lifetimes, for example through the carbon intensity of the electricity they provide. These can be compared to alternatives, such as the carbon intensity of the national grid network, to advocate for cleaner sources of power.

The inputs for the environmental impact of the system are included in the GHG inputs file, which is located in the Impact folder of your location folder. Let’s take a look at the inputs for the Bahraich case study:

0 1 2
0 PV GHGs 3000.000 kgCO2/kWp
1 PV O&M GHGs 5.000 kgCO2/kWp p.a.
2 PV GHG decrease 5.000 % p.a.
3 Storage GHGs 110.000 kgCO2/kWh
4 Storage O&M GHGs 5.000 kgCO2/kWh p.a.
5 Storage GHG decrease 5.000 % p.a.
6 Diesel generator GHGs 2000.000 kgCO2/kW
7 Diesel generator GHG decrease 0.000 % p.a.
8 Diesel fuel GHGs 2.000 kgCO2/litre
9 Diesel O&M GHGs 10.000 kgCO2/kW p.a.
10 BOS GHGs 200.000 kgCO2/kW
11 BOS GHG decrease 2.000 % p.a.
12 PV installation GHGs 50.000 kgCO2/kW
13 PV installation GHG decrease 0.000 % p.a.
14 Diesel installation GHGs 50.000 kgCO2/kW
15 Diesel installation GHG decrease 0.000 % p.a.
16 Connection GHGs 10.000 kgCO2/household
17 Kerosene GHGs 0.055 kgCO2/hour
18 Grid GHGs (initial) 0.800 kgCO2/kWh
19 Grid GHGs (final) 0.400 kgCO2/kWh
20 Grid extension GHGs 290000.000 kgCO2/km
21 Grid infrastructure GHGs 1200000.000 kgCO2
22 Inverter GHGs 75.000 kgCO2/kW
23 Inverter GHG decrease 2.000 % p.a.
24 Inverter lifetime 4.000 years
25 Inverter size increment 1.000 kW
26 Misc. GHGs 0.000 kgCO2/kW
27 General O&M GHGs 200.000 kgCO2 p.a.

Similarly to the financial inputs, the environmental inputs consider the initial impact of installing the technologies (the embedded GHG emissions from their manufacture) and the impact of maintaining them, as well as the potential for technologies to decrease their impact over time as manufacturing becomes more efficient, for example. These data are typically much more difficult to identify values for as the environmental impact is rarely considered in such detail, if at all, as a secondary metric to the financial impact. As a result it may be better to either use the default values provided or set them to zero to disregard them depending on the nature of your investigation; either may be appropriate, as long as the decision is acknowledged and justified where necessary. The table below describes in more detail what each variable means:

Variable Explanation
PV GHGs GHGs of PV modules in kgCO2/kWp
PV O&M GHGs The annual cost of maintaining PV modules in kgCO2/kWp
PV GHGs decrease The annual GHG decrease of PV modules in %
Storage GHGs The GHGs of storage in kgCO2/kWh
Storage O&M GHGs The annual GHGs of maintaining storage in kgCO2/kWh
Storage GHGs decrease The annual GHG decrease of storage in %
Diesel generator GHGs GHGs of a diesel generator in kgCO2/kW
Diesel generator GHG decrease The annual GHG decrease of a diesel generator in %
Diesel fuel GHGs GHGs of diesel fuel in kgCO2/litre
Diesel O&M GHGs The annual GHGs of maintaining the diesel generator in kgCO2/kWh
BOS GHGs GHGs of balance of systems (BOS) components for PV in kgCO2/kWp
BOS GHGs decrease The annual GHG decrease of BOS components in %
PV installation GHGs GHGs of installing PV modules in kgCO2/kWp
PV installation GHGs decrease The annual GHG decrease of installing PV modules in %
Diesel installation GHGs GHGs of installing diesel generators in kgCO2/kW
Diesel installation GHGs decrea se The annual GHGs decrease of installing diesel generators in %
Connection GHGs The GHGs of connecting a household to the system in kgCO2
Kerosene GHGs The GHGs of using a kerosene lamp for one hour in kgCO2
Grid GHGs (initial) The GHGs of grid electricity at the start of the time period in kgCO2/kWh
Grid GHGs (final) The GHGs of grid electricity at the end of the time period in kgCO2/kWh
Grid extension GHGs The GHGs of extending the grid by 1 km in kgCO2
Grid infrastructure GHGs The GHGs of transformers (etc.) to connect the system to the grid in kgCO2
Inverter GHGs GHGs of an inverter in kgCO2/kW
Inverter GHGs decrease The annual GHG decrease of an inverter in %
Inverter lifetime The lifetime of an inverter in years
Inverter size increment The variety of available sizes of inverters in kW
Misc. GHGs General miscellaneous capacity-dependent GHGs for the system in kgCO2/kW
General O&M GHGs General miscellaneous annual GHGs for the system in kgCO2 per year

Almost all of the variables in the above table are environmental analogues to those in the financial inputs and therefore their descriptions will not be repeated here. The exceptions to this are Grid GHGs (initial) and Grid GHGs (final), which describe the emissions intensity of the grid network at the start and end of the considered lifetime of the system respectively. These allow the user to take into account how the electricity grid might be decarbonised over time in line with national policy objectives, which would have a subsequent impact on the GHGs of a system using grid electricity throughout its lifetime.

In general many of the technologies have relatively carbon-intensive manufacturing processes, such as processing silicon for solar panels and smelting metals for balance of systems components and wiring, whilst diesel fuel has notoriously high emissions from its usage. Emissions associated with operation and maintenance could come from the maintenance itself (for example replacement parts) or other considerations, such as the GHGs of a worker travelling to the site; in practice, however, these O&M emissions are usually dwarfed by the embedded emissions of equipment and those from diesel fuel and the national grid. Emissions from transporting equipment are not explicitly included but can be implicitly included by adding them to the appropriate variables, for example setting PV GHGs to a value including both the emissions from manufacturing a panel and from shipping it to the installation site (both in terms of capacity, here kgCO2/kWp).

Complete the GHG inputs CSV file with the financial information for your investigation.

Optimisation inputs

The optimisation process in CLOVER is mostly automatic but in order for it to work we need to state the conditions under which it should operate. CLOVER performs a large number of system simulations, each with different combinations of generation and storage capacity sizes, and appraises them based on their technical, financial and environmental performances; depending on our interests, any of them might be considered “the best”. For this reason we need to provide CLOVER with some details about what we consider to be the “optimum” system using two variables that we define:

  • The threshold criterion, which determines whether a simulated system meets the standards required to be considered as a potential optimum system, and
  • The optimisation criterion, which determines which of the potential systems is selected to be the best.

Simply put, the threshold criterion decides whether a system meets our stated needs and, as many systems are likely to be able to meet our needs, the optimisation criterion selects the one that performs the best according to its financial or environmental impact. As an example, consider that we want to design a system which provides electricity 95% of the time or more: clearly many systems will be able to do that, some much larger than would be affordable, so we decide that the one which provides the lowest cost of electricity would be best. Here we would define the threshold criterion to be Blackouts (from earlier set to a value of 0.05 (i.e. a maximum of 5% blackouts), whilst the optimisation criterion would be the levelised cost of used electricity in $/kWh (LCUE, explained further later) with the lowest being the best. CLOVER would then identify a system which meets those two criteria, and give us a range of other impact metrics as well.

We also need to provide information about scenario we are investigating: optimising over different time periods will potentially provide different results as resource generation, load demands, technological performance and degradation all change over time. CLOVER uses a step-by-step optimisation process which divides the total investigation lifetime into shorter time periods; this allows us to replicate the process of designing a system to meet some future needs, then revisiting the system after a few years to upgrade it as necessary to meet a growing demand or maintain its performance. This also allows us to consider that additional capacity in the context of what has already been installed, adding only what is necessary rather than overhauling the existing equipment.

The inputs for the optimisation parameters are included in the Optimisation inputs file, which is located in the Optimisation folder of your location folder. Let’s take a look at the inputs for the Bahraich case study:

0 1 2 3
0 Scenario length 12 years NaN
1 Iteration length 4 years NaN
2 PV size (min) 0 kWp NaN
3 PV size (max) 1 kWp NaN
4 PV size (step) 5 kWp NaN
5 PV size (increase) 0 kWp Set to 0 to ignore
6 Storage size (min) 0 kWh NaN
7 Storage size (max) 1 kWh NaN
8 Storage size (step) 5 kWh NaN
9 Storage size (increase) 0 kWh Set to 0 to ignore
10 Threshold criterion Blackouts Name of column from appraisal NaN
11 Threshold value 0.05 Max/min value permitted (see guidance) NaN
12 Optimisation criterion LCUE ($/kWh) Name of column from appraisal NaN

Some of the variables included in the Optimisation inputs CSV file are not used by the current optimisation function. These were left over from previous processes which have since been improved to increase the speed and efficiency of the overall optimisation. These previous functions (and their input variables) are deprecated, meaning that they are not used by the standard processes in the model but are still present in dormant sections of the code and can be used if specifically desired by the user. For clarity, these functions are not covered in this document but their variables are still included in the Optimisation inputs CSV file for completeness.

The table below describes in more detail what each variable means:

Variable Explanation
Scenario length Total length of the investigation period in years
Iteration length Length of each step-by-step time period in years
PV size (min) Minimum size of PV capacity to be considered in kWp
PV size (max) Deprecated
PV size (step) Optimisation resolution for PV size in kWp
PV size (increase) Deprecated
Storage size (min) Minimum size of storage capacity to be considered in kWh
Storage size (max) Deprecated
Storage size (step) Optimisation resolution for storage size in kWh
Storage size (increase) Deprecated
Threshold criterion Criterion for identifying sufficient systems
Threshold value Value required for a system to be considered sufficient
Optimisation criterion Criterion for identifying optimum system

Two variables control the length of the investigation period and that of each of the sub-periods, with the total Scenario length comprised of several Iteration length. For example, setting Scenario length = 12 and Iteration length = 4 would mean that there would be three distinct periods: the first considering the first four years, the second considering the next four years (including the performance of the system that was already installed for the period before), and the third considering the last set of four years (again including the periods before). Scenario length must be a multiple of Iteration length for the optimisation process to work, and Scenario length can be any length up to the total investigation lifetime we defined in defined earlier to be 20 years.

The optimisation process in CLOVER first considers a system with the smallest generation and storage capacity and gradually increases it until it finds one that meets the threshold criterion. The first system it considers at the start of the investigation period, with the smallest installed capacity, is defined by PV size (min) and Storage size (min). These variables identify the starting point of the optimisation which, for many, would be no installed capacity at all - meaning PV size (min) = 0 and Storage size (min) = 0. If there is already a system in place then set these variables to the capacity of that system. When CLOVER moves on to the second (or later) iterations during the optimisation process it automatically considers the capacity that was installed during the previous time period.

The optimisation function requires the user to define the resolution of the investigation, defined through the variables PV size (step) and Storage size (step) respectively: once CLOVER has investigated a system it then analyses one with a larger capacity, with the increase in capacity of the next system defined by these two variables. For example, with PV size (step) = 1 CLOVER would consider systems with PV size = 0, 1, 2, 3, ... whereas PV size (step) = 5 would consider PV size = 0, 5, 10, 15, ..., with the same logic being true for Storage size (step). Both variables can be set to different values, and can be non-integers. For an investigation of a theoretical system then choosing a round number for the step size might be more convenient, but for a real investigation it could be better to use the real available capacity of the equipment being installed. For example, if you know that the system will be build using solar panels with a capacity of 350 Wp, you could choose to use PV size (step) = 0.35.

Threshold criterion is the name of the variable being used to decide whether a system provides sufficient performance to be considered as a potential optimum system, as described earlier, with Threshold value being the value it must meet. The choices for Threshold criterion are described later in described later and CLOVER knows automatically whether the Threshold value should be considered as a maximum or minimum value: for example, if Threshold criterion = Blackouts then CLOVER interprets Threshold value = 0.05 as systems are permitted to have blackout periods for a maximum of 5% of the time. Optimisation criterion, meanwhile, is the variable being used to select the optimum system and CLOVER similarly knows whether this should be interpreted as a maximum or minimum: for example, Optimisation criterion = LCUE ($/kWh) would be used to find the lowest cost of electricity. Take care that the inputs for Threshold criterion and Optimisation criterion are spelled correctly, otherwise the optimisation process will not work.

Considerations

CLOVER can take a number of variables as either the threshold or optimisation criteria and these should be chosen to best reflect the context of the investigation and its goals. Typically the threshold criterion relates to the technological performance of the system on the basis that, in order for a system to be viable, it needs to be able to provide a minimum level of service to the community which is (almost always) based on its core technical functionality, rather than economic or environmental factors. The level of service availability, either in terms of the time energy is (un)available or the proportion of demanded that should be met, are the most commonly used threshold criteria. Selecting an appropriate threshold value will vary depending on the situation, for example a system for basic domestic applications could permit blackouts 5-10% of the time whilst one for a hospital may need 0% system downtime.

The optimisation criterion, meanwhile, is typically a measure of the system impact either in financial or environmental terms. Most commonly this is the levelised cost of used electricity (LCUE, measured in $/kWh), which considers the cost of power over the lifetime of the system and is normally most relevant to system designers, but could also be other financial metrics such as the total system cost which may be more relevant to donor-led projects. Environmental analogues of these metrics, such as the emissions intensity of electricity or the cumulative GHG emissions, may be more relevant for projects driven by climate change objectives.

Whilst a single criterion must be selected for use in the optimisation process, as we will see in we will see later the optimisation process gives us all of the available outputs and so we can investigate all of them for an optimum system configuration. Using different optimisation criteria may yield different results but often the optimum systems will be relatively similar: for a given level of service availability, it is likely that the capacity of a system optimised for lowest cost of electricity will be similar to one optimised for lowest cumulative cost, but may not be identical.

Choosing the resolution of an optimisation is a trade-off between precision and computation time. Taking the above example of 1 kWp or 5 kWp resolutions, the former method would be more likely to suggest a system closer to the true optimum: for example, if the true optimum system (if it were possible to know it exactly) has PV size = 7 then the former method would be able to find it, but the latter method would suggest either PV size = 5 or PV size = 10, depending on how the other aspects of system influence this. Even if the true optimum system is actually PV size = 7.2, the former method still gets closer.

The importance of a precise answer will depend on the requirements of your investigation, the size of the system, your available processing power and your patience, so there is no exact answer for the “best” step sizes to use. In general, it is good practice to run an initial optimisation with a low resolution (e.g. PV size = 10) to get an idea of the order of magnitude of the system: if the optimum output for this trial run is PV size = 20, it would be appropriate to re-run the optimisation with a higher resolution (e.g. step sizes of 1 kWp or 5 kWp) to gain greater precision. If the output is PV size = 300, it might be better to increase the step size (e.g. to 20 kWp) to reduce computational time.

The optimisation process CLOVER uses provides the optimum system for the iteration period under consideration, which is not necessarily the same as one for the entire lifetime of the system. This is to replicate real-life system design and the timeframes of community energy projects, where plans are built around time horizons of a few years owing to practical constraints such as funding, the limits of demand prediction, or the likelihood of altering the business model. This also matches a reasonable timeframe of making major upgrades to the system, for example returning to the site every few years to perform capacity upgrades to meet a growing demand. As such CLOVER identifies the optimum system for the next short-term time window, providing the system that best meets the requirements for the next stage of design, before moving on to the next stage in time. This allows users to know the optimum system for the immediate future and what subsequent system upgrades might look like to maintain that optimum performance. As will all predictions the further into the future you consider the greater uncertainty there is, but remember that you can always return in a few years’ time to re-run your optimisation when it’s time to upgrade your system.

As a result the of the precision of your system, the CLOVER optimisation process might suggest different pathways of capacity sizing over the lifetime of the system. In the example above, if a system requires PV size = 7.2 in its first period and PV size = 12.1 in its second then using a PV size (step) of 1 kWp would probably give PV size = 7 and PV size = 12, but using a step size of 10 kWp might give PV size = 10 for both periods. The latter case might have evaluated the relative costs and benefits of increasing the capacity to PV size = 20 and found that (for example) increasing the storage capacity instead was more worthwhile. The precision we chose has therefore locked the two optimisations into different pathways, one with a larger PV capacity and one with a larger storage capacity; both will provide the same level of service (as the threshold criteria are the same in both cases) but the optimisation impacts such as the costs will be different. In some cases this effect can be exacerbated over several time periods, but in general the most effective way to mitigate this is through using higher precision in your optimisations to stay as close as possible to the true optimum system.

Complete the Optimisation inputs CSV file with the optimisation information for your investigation.

Performing an optimisation of an energy system

Preparation

We are now able to perform an optimisation of an energy system using the Optimisation module. This relies on all of the information we have input and generated previously in the electricity system simulation section and the earlier parts of this section. This will let us identify the optimum system, find its solar and battery capacity, and get information about its technological performance and its financial and environmental impacts.

To perform an optimisation we must first run the Optimisation script (using the green arrow in the Spyder console), which we do here using the following:

The optimisation function we will use does not take any arguments from the console as they are all included in the previous CSV files. We can override them in the function but this is generally for specific applications which are not relevant here.

Running an optimisation

To run an optimisation we run the following function in the console, saving the output as a variable called example_optimisation so we can look at the outputs in more detail:

example_optimisation = Optimisation().multiple_optimisation_step()

This will run the optimisation function, which automatically simulates a variety of systems with different capacity sizes until it finds the optimum configuration. The optimisation process can take a long time to complete, ranging from minutes to hours depending on your scenario and available computing resources (hence the advice to begin at a relatively low resolution to get an idea of the expected system size). If you need to cancel the optimisation function before it completes, click on the console and press Ctrl + C on your keyboard.

Whilst the optimisation function runs it outputs some information to the screen to update on its progress. An example is below:

Step 1 of 3

Time taken for simulation: 0.16 seconds per year

Current system: Blackouts = 0.1, Target = 0.05

In this case, the function is considering the first four-year period in the twelve-year lifetime (Step 1 of 3). As before when running a simulation, it prints information about the speed at which the simulations are being performed. Finally it presents some information about the performance of the system it just simulated in terms of the chosen threshold criterion (Blackouts = 0.1) and the desired target set by the Optimisation inputs CSV file (Target = 0.05).

In this case, we can notice that all of the systems have Blackouts = 0.1 or lower, even for the very first system that is simulated which has PV_size = 0 and storage_size = 0. This is because the Diesel backup = Y and Diesel backup threshold = 0.1 (from earlier) which means that the diesel generator is activated to provide Blackouts = 0.1 at the very least. Because we set the threshold criterion higher than this, the system is unable to use diesel alone to meet the requirements thereby forcing it to install some renewable capacity to reach Blackouts = 0.05. We could have set Diesel backup threshold = 0.05 to potentially allow the use of diesel generation to meet our target, but in our case this results in a diesel-dominated system which doesn’t provide a good example!

A few other statements are shown in the console that update you on what the optimisation process is doing. Using single line optimisation means that CLOVER is scanning along a fixed capacity of either PV or storage whilst varying the other, whilst Increasing storage size and Increasing PV size describe the steps CLOVER is taking to identify the optimum system by checking larger configurations. These are for information only so there is no need to do anything with this information.

Finally, when the optimisation is complete, you receive the message:

Time taken for optimisation: 10:15 minutes

This lets you know how long the entire optimisation process took (in this case just over 10 minutes). This is for information only but you can use it to judge how to amend your resolution for your next optimisation, or to know approximately how long you will need to wait next time you optimise the system.

Opening the example_optimisation variable allows us to view the results of the optimisation function, which are presented in a table. Each row corresponds to an iteration period (in our case, three) with the columns describing the results for each stage of the optimisation. There is a large number of results and so we will discuss them in more detail later.

Saving optimisation results and opening saved files

Similarly to the reasons for saving simulation results described earlier it is important to save the optimisation results for future reference. It is especially important because of the time it takes to run optimisations, which can be much longer than any single simulation.

CLOVER provides a function to save the output of optimisations as CSV files, storing the data much more conveniently. To save an output (optimisation_name) we need to have first stored it as a variable, and choose a filename (filename) to store it (note that the filename variable in this function must be a string). In our case optimisation_name = example_optimisation, and we choose file_name = 'my_saved_optimisation'. To save the optimisation results we run the function:

Optimisation().save_optimisation(optimisation_name = example_optimisation,
        filename = 'my_saved_optimisation')

This function creates a new CSV file in the Saved optimisations folder in the Optimisation folder in your location folder titled my_saved_optimisation.csv. If the filename variable is left blank, the title of the CSV defaults to the time the save operation was performed. Be aware that running this function with a filename that already exists will overwrite the existing file.

To open a saved file, we use the name of the CSV file to open the correct result, for example:

opened_optimisation = Optimisation().open_optimisation(filename = 'my_saved_optimisation')

This will open the my_saved_optimisation.csv file and record the data as a new variable, opened_optimisation, which will be in the same format as the original saved variable example_optimisation.

Optimisation results

Our optimisation function gives us a large number of results in its output variable. Let’s open the example saved optimisation file, located in the Bahraich folder:

0 0 0
Start year 0.000 4.000 8.000
End year 4.000 8.000 12.000
Initial PV size 10.000 20.000 30.000
Initial storage size 40.000 70.000 100.000
Final PV size 9.600 19.200 28.800
Final storage size 34.915 60.884 86.162
Diesel capacity 0.000 0.000 0.000
Cumulative cost ($) 29618.740 46665.340 58062.030
Cumulative system cost ($) 28863.620 45517.130 56608.180
Cumulative GHGs (kgCO2eq) 55702.070 110820.050 169535.870
Cumulative system GHGs (kgCO2eq) 48801.380 98672.910 151484.150
Cumulative energy (kWh) 53963.453 153124.929 310774.471
Cumulative discounted energy (kWh) 44290.408 99759.179 160367.390
LCUE ($/kWh) 0.652 0.456 0.353
Emissions intensity (gCO2/kWh) 904.341 644.395 487.441
Blackouts 0.043 0.039 0.049
Unmet energy fraction 0.029 0.026 0.030
Renewables fraction 0.764 0.767 0.768
Total energy (kWh) 53963.453 99161.476 157649.542
Total load energy (kWh) 54635.778 100110.598 159832.375
Unmet energy (kWh) 1610.022 2633.543 4726.531
Renewable energy (kWh) 22179.611 41880.569 69248.362
Storage energy (kWh) 19067.076 34183.638 51891.289
Grid energy (kWh) 12716.766 23097.270 36509.891
Diesel energy (kWh) 0.000 0.000 0.000
Discounted energy (kWh) 44290.408 55468.771 60608.211
Kerosene displacement 0.954 0.965 0.960
Diesel fuel usage (l) 0.000 0.000 0.000
Total cost ($) 29618.740 17046.600 11396.690
Total system cost ($) 28863.620 16653.510 11091.050
New equipment cost ($) 25200.000 13308.900 8218.550
New connection cost ($) 400.000 262.440 172.190
O&M cost ($) 3159.960 2953.460 2560.360
Diesel cost ($) 0.000 0.000 0.000
Grid cost ($) 103.660 128.720 139.960
Kerosene cost ($) 755.130 393.090 305.640
Kerosene cost mitigated ($) 17295.780 11875.070 7921.960
Total GHGs (kgCO2eq) 55702.070 55117.980 58715.820
Total system GHGs (kgCO2eq) 48801.380 49871.530 52811.240
New equipment GHGs (kgCO2eq) 37350.000 31617.150 27556.470
New connection GHGs (kgCO2eq) 40.000 40.000 40.000
O&M GHGs (kgCO2eq) 1800.000 2600.000 3400.000
Diesel GHGs (kgCO2eq) 0.000 0.000 0.000
Grid GHGs (kgCO2eq) 9611.380 15614.390 21814.770
Kerosene GHGs (kgCO2eq) 6900.680 5246.450 5904.580
Kerosene GHGs mitigated (kgCO2eq) 142468.860 143334.180 139938.040

Note that here we have displayed the outputs vertically (rather than horizontally as in the default) so that they are easier to see. These results are automatically generated as a result of the optimisation process but it is also possible to calculate them for a specific case study system, described later when we return to system performance.

Many of these variables have similar names, so here are some pointers on interpreting them:

  • Cumulative means that the variable is a running total since the start of the system lifetime (i.e. the current period and all previous periods)
  • New means the variable includes only the current period
  • Cost values are all discounted costs, meaning they take into account the discount rate, and are presented in terms of $ at the start of the lifetime
  • System means the electricity system (PV and storage capacity, O&M, diesel, grid, connections)
  • Total refers to the costs from all sources (i.e. the system and kerosene expenditure) a each time period
  • Energy is either the amount of energy or (when specified) the discounted energy which takes into account the discount rate

These identifiers (or the names themselves) should provide enough description to work out what each variable means. Now let’s consider a few of the most relevant ones that you’re most likely to use in more detail:

Variable Explanation
Start / End year The first and last years in each considered period
Initial PV / storage size Installed capacity of PV/storage at the start of the period
Final PV / storage size Equivalent capacity of PV/storage at the end of the period, after degradation
Diesel capacity Installed capacity of diesel generator required for backup (kW)
LCUE ($/kWh) Levelised cost of used electricity up to the end of the simulation period ($/kWh)
Emissions intensity (gCO2/kWh) Emissions intensity up to the end of the simulation period (gCO2/kWh)
Blackouts Proportion of time where blackouts occurred for each iteration period
Unmet energy fraction Proportion unmet energy for each iteration period
Renewables fraction Proportion energy from PV and storage for each iteration period
Kerosene displacement Proportion kerosene mitigated during each iteration period
Cumulative cost ($) Running total of cumulative costs over the system lifetime in $
Cumulative GHGs (kgCO2eq) Running total of cumulative GHGs over the system lifetime in kgCO2eq

The first variables are useful in characterising the iteration period (Start year and End year) and knowing the capacity of the system that was installed (Initial PV size and Initial storage size), possibly the most important variables in terms of describing the system itself. The Final PV size and Final storage size describe the state of the equipment at the end of the iteration period, incorporating the effects of degradation. Note that for the next iteration period, CLOVER may choose to “refresh” the installed capacity either by returning it to the same initial size from the previous iteration or increasing it, or leave it “as is” and not add any further capacity. In the latter case the final size from the previous iteration would be the initial size of the next; this is relatively common for systems without growing load profiles. Finally Diesel capacity describes the size of the diesel generator installed to provide power as a backup.

The remaining variables in the table are useful to use as either threshold or optimisation criteria for designing your system: many of the variables in example_optimisation could be used for this purpose, but these are the most commonly used and most likely to be relevant for your investigation. Bear in mind that the input for Threshold criterion or Optimisation criterion must match the variable name exactly otherwise the function will fail. For example, LCUE ($/kWh) would work but LCUE would not.

Two important variables relate to the financial and environmental impact of the system at each point in its lifetime: the levelised cost of used electricity (LCUE, $/kWh) and emissions intensity (gCO2/kWh). These are convenient metrics of capturing the performance of the system per unit of electricity and so are readily comparable to other systems for the same (or other) applications. The LCUE is the most common optimisation criterion as it conveniently captures core financial information which is readily comparable to other situations. LCUE considers only the energy used by the community, explicitly defined as the useful electricity actually consumed rather than (for example) all of the electricity that was generated, some of which was likely dumped if demand was already met. Furthermore this definition accounts for blackout periods when electricity was demanded, but unmet.

For each iteration step these variables provide information about the LCUE and emissions intensity by the end of that step: for example, the LCUE over the first time period is $0.65/kWh but falls to $0.35/kWh by the end of the optimisation period over the whole lifetime. This is because the impacts of deploying the equipment occur at the start of each period but their benefits, in terms of the electricity they provide, are received over the total remaining lifetime of the system including subsequent iteration periods. The assumption here is that a community energy project would need to purchase equipment outright before it can be deployed, reflecting common practice, but would not capture more nuanced financial plans which would require further development outside of CLOVER.

The next set of variables describe the performance of the system during each iteration period. These can be used as optimisation criteria but are also very useful as threshold criteria and each period is considered independently to ensure the minimum performance threshold is met throughout. If this were not the case, if the first period performed very well then the second could perform below the expectation of the threshold, if the average over the entire period still satisfied the defined threshold value. As before Blackouts and Unmet energy fraction describe the service unavailability in terms of the proportion of time electricity is not available and the proportion of energy demand that is not satisfied by the system, and when used as a threshold criterion are defined as the maximum allowable value for a system to be sufficient. Renewables fraction describes the proportion of energy that was supplied by either solar or storage (i.e. not from the grid or diesel generation), whilst Kerosene displacement describes the proportion of kerosene usage that was mitigated by the availability of electricity. For the latter two variables, these are considered a minimum allowable value when used as a threshold criterion.

Finally, Cumulative cost ($) and Cumulative GHGs (kgCO2eq) are running totals of the cumulative incurred costs or GHGs up to the point of each iteration period. These are the best values for capturing the entire impact of the scenario over its lifetime, including impacts from all sources including kerosene usage. For the impacts of the electricity system alone, Cumulative system cost ($) and Cumulative system GHGs (kgCO2eq) can instead be used (if kerosene usage was not already disregarded earlier). In this case, the total lifetime impact of the system (and residual kerosene usage) was that it cost around $58,000 and emitted around 170 tCO2 to supply power to the community of 100 households for 12 years.

You now should have everything you need to investigate your scenarios, perform optimisations and design electricity systems. Good luck!

Troubleshooting

Most of the Optimisation functionality is contained within the Optimisation().multiple_optimisation_step() function and so potential issues are most likely to come either from how the module gathers data from other parts of CLOVER or from the input CSV files.

  • Ensure that the self.location variable is correct in all of the modules that Optimisation imports
  • Check that your Finance inputs, GHG inputs and Optimisation inputs, CSVs are completed with the scenario you want to investigate, and any changes are saved in the CSV file before running another simulation
  • Check that your Scenario inputs CSV is completed with the scenario you want to investigate and the Energy_System module is working correctly
  • Ensure that you use the correct filename when saving and opening previous simulations
  • When running optimisations, remember to save the output of Optimisation().multiple_optimisation_step() as a variable

Extension and visualisation

Changing parameter optimisation

Investigating the design of a system under a given threshold criterion allows us to identify the optimum configuration under those conditions, but in many cases the target value of the threshold criterion might be negotiable. A common example is the tradeoff between the reliability of the system and the cost of electricity: with all other scenario conditions being the same, a more reliable system will need greater generation and storage capacities which will increase the investment required and so increase the cost of electricity. It is often interesting, therefore, to investigate a range of values for the threshold criterion to see what effect it has on the resulting optimisation criterion, and from those options select a system that best suits our needs.

We can demonstrate the above example by considering a system with the Optimisation criterion as LCUE ($/kWh) and the Threshold criterion as Blackouts as before, but with a range of Threshold value. Whereas before we set this to be 0.05, we now want to optimise using several options ranging from 0.25 to 0.05 in steps of 0.05. All of the other inputs in the Optimisation inputs CSV file are the same as the earlier example but we have set Diesel backup = N in the Scenario inputs CSV file to avoid the diesel generator backup improving the reliability, in order to better demonstrate our goal here.

We can use the below function to automatically perform several optimisations in a row and save the results to CSV files:

Optimisation().changing_parameter_optimisation(parameter = 'Threshold value',
    parameter_values = [0.25,0.20,0.15,0.10,0.05],
    results_folder_name = 'Changing parameter example')

This function takes more variables than the usual Optimisation().multiple_optimisation_step() function as it repeatedly uses that function, with changing parameters, to perform several optimisations. Be aware that, by doing this, the Optimisation().changing_parameter_optimisation(...) function takes several times longer to finish and, when investigating systems with the strictest threshold values, can take much more time than previous optimisations you might have performed.

We define which parameter we want to change each time using the parameter input, which can correspond to any variable in the Optimisation inputs CSV file. Here we want to investigate the effect of using different values for the threshold criterion, so we set parameter = 'Threshold value'. Next we need to specify the values we want to investigate which we input as a list-type variable; using the information above, we therefore input parameter_values = [0.25,0.20,0.15,0.10,0.05]. The list of parameter_values can be as long or short as desired. This will run the optimisation function sequentially for each value (Threshold value = 0.25, Threshold value = 0.20, …, Threshold value = 0.05) by automatically rewriting the Optimisation inputs CSV file: be aware that the final rewrite will leave the final Threshold value in the file, so you may need to remember to amend this if you use the usual Optimisation().multiple_optimisation_step() again.

Finally, the results of each optimisation are saved in a folder with the name results_folder_name in the Saved optimisations folder in your Optimisation folder, which itself is in the overall file structure for your location. Here we use results_folder_name = 'Changing parameter example' to specify the place where the outputs should be saved. The folder must be manually created beforehand in order to save the files there, otherwise they will be saved in a new folder with the date and time the function was performed.

Whilst running, the function will save the outputs of each optimisation as a CSV with the name Threshold value = 0.25.csv (and so on) to allow you to investigate each system individually afterwards. Once the entire function is complete, it outputs a summary file of the final results for each optimised system in the file Threshold value lifetime summary of results.csv (the name of this file will change if you used a different parameter). This is composed of the final row of each optimisation so bear in mind that some of the data refers to a single iteration period when interpreting the results and refer to the section on optimisation results for guidance. If you need to cancel the function for any reason, the output CSVs that have already been saved will still be available but this final CSV will not, as it is compiled at the end of the process (but can be manually compiled if necessary).

Using parameter = 'Threshold value' is the most common usage of this function to set the process running self-sufficiently, allowing you to leave it to work away in the background without intervention and return results when they are ready. It is also possible to use it for other types of investigations, but be sure to think carefully how these would be interpreted by the function. For example, if you wanted to investigate the effect on the system of either using a threshold value of 0.05 for either the Blackouts or Unmet energy fraction, you could use parameter = 'Threshold criterion' and parameter_values = ['Blackouts', 'Unmet energy fraction']. Or if you wanted to find an optimum systems with the lowest cost of electricity or lowest emissions intensity, you could use parameter = 'Optimisation criterion' and parameter_values = ['LCUE ($/kWh)', 'Emissions intensity (gCO2/kWh)']. Owing to the variety of potential combinations they have not all been tested so unexpected bugs may occur, in which case please get in touch.

Interpreting optimisation results

The meaning and implications of your optimisation results will depend very strongly on your scenario and the goals of your investigation: CLOVER can provide results but the value is in interpreting them and applying them in the context of your project. With that in mind, we can use the example in the changing parameter optimisation section to demonstrate some of the techniques that could be useful.

As stated earlier, the goal of this investigation was to see what effect different levels of reliability (from Blackouts = 0.25 to Blackouts = 0.05) would have on the optimum system design, defined to be the one with the lowest LCUE. Let’s open the results we generated previously:

0 1 2 3 4
Parameter value 0.250 0.200 0.150 0.100 0.050
Start year 0.000 0.000 0.000 0.000 0.000
End year 12.000 12.000 12.000 12.000 12.000
Step length 4.000 4.000 4.000 4.000 4.000
Optimisation length 12.000 12.000 12.000 12.000 12.000
Maximum PV size 20.000 20.000 25.000 25.000 30.000
Maximum storage size 55.000 65.000 70.000 85.000 100.000
Maximum diesel capacity 0.000 0.000 0.000 0.000 0.000
LCUE ($/kWh) 0.268 0.282 0.301 0.320 0.353
Emissions intensity (gCO2/kWh) 444.411 437.315 460.682 452.121 487.441
Blackouts 0.226 0.177 0.127 0.085 0.044
Unmet fraction 0.161 0.123 0.089 0.059 0.029
Renewables fraction 0.471 0.460 0.449 0.434 0.429
Storage fraction 0.248 0.275 0.299 0.323 0.338
Diesel fraction 0.000 0.000 0.000 0.000 0.000
Grid fraction 0.281 0.265 0.252 0.244 0.233
Total energy (kWh) 266649.494 279106.252 290770.084 300815.451 310774.471
Total load energy (kWh) 314578.751 314578.751 314578.751 314578.751 314578.751
Unmet energy (kWh) 50503.688 38815.038 27883.654 18448.425 8970.096
Renewable energy (kWh) 125602.499 128275.629 130486.554 130486.554 133308.542
Storage energy (kWh) 66216.550 76869.370 87028.926 97074.293 105142.003
Grid energy (kWh) 74830.445 73961.253 73254.605 73254.605 72323.927
Diesel energy (kWh) 0.000 0.000 0.000 0.000 0.000
Discounted energy (kWh) 138250.028 144964.140 150964.432 155792.252 160367.390
Total cost ($) 49206.500 48696.650 50056.010 52631.400 58062.030
Total system cost ($) 37102.430 40824.860 45366.490 49799.110 56608.180
New equipment cost ($) 29446.250 32795.160 36829.580 40635.940 46727.450
New connection cost ($) 834.630 834.630 834.630 834.630 834.630
O&M cost ($) 6437.500 6815.780 7325.660 7951.920 8673.780
Diesel cost ($) 0.000 0.000 0.000 0.000 0.000
Grid cost ($) 384.060 379.300 376.630 376.630 372.340
Kerosene cost ($) 12104.060 7871.810 4689.520 2832.290 1453.860
Kerosene cost mitigated ($) 26442.590 30674.860 33857.150 35714.370 37092.810
Kerosene displacement 0.678 0.782 0.865 0.918 0.960
Diesel fuel usage (l) 0.000 0.000 0.000 0.000 0.000
Total GHGs (kgCO2eq) 261382.140 218776.770 193499.040 172452.620 169535.870
Total system GHGs (kgCO2eq) 118501.880 122057.280 133952.620 136005.050 151484.150
O&M GHGs (kgCO2eq) 5500.000 5900.000 6400.000 7000.000 7800.000
Diesel GHGs (kgCO2eq) 0.000 0.000 0.000 0.000 0.000
Grid GHGs (kgCO2eq) 48633.790 48049.120 47629.300 47629.300 47040.540
Kerosene GHGs (kgCO2eq) 142880.270 96719.480 59546.420 36447.560 18051.710
Kerosene GHGs mitigated (kgCO2eq) 300912.540 347073.330 384246.390 407345.240 425741.080

Once again we have displayed the outputs vertically to make them easier to see. The results in this table are characterised from left to right in terms of the Parameter value, here our range from 25% to 5% blackouts. An important note here is that Total now refers to the lifetime cumulative cost, rather than the final iteration as it was before. The fraction of energy from each source considers only the energy used in the system (i.e. after the Unmet fraction has been taken out), and Renewables fraction refers to energy from renewable generation used directly, with Storage fraction accounted for separately. The differences in naming conventions come from different versions of the model which have been updated and modified over time, so bear this in mind and refer to the documentation when interpreting the outputs.

Let’s look at how the different parameter_values we used in the function impact the LCUE graphically:

_images/output_17_0_opt.png

As expected the value of LCUE, our chosen optimisation criterion, increases for more reliable systems: if the community are willing to pay more for electricity then the most reliable system may be appropriate, but if not then perhaps a less reliable but more affordable system would be better. It is worth noting here that whilst we set Blackouts to be the threshold criterion, the actual levels of blackouts in each system was always lower:

Parameter value Blackouts
0 0.25 0.226
1 0.20 0.177
2 0.15 0.127
3 0.10 0.085
4 0.05 0.044

This is because the actual value of Blackouts must always be equal to or lower than the threshold value, but this is worth noting when considering the difference between the criteria we set for a system and its actual performance.

After seeing these results it is also good to evaluate the resolution of the optimisations that we used. Our Optimisation inputs CSV used PV size (step) as 5 kWp: given that the installed capacities (here shown in the Maximum PV size variable) are in the range 20-30 kWp, this step size is likely too large to give us a good resolution and the should probably have been smaller to avoid unnecessary oversizing. The Storage size (step) value of 5 kWh was probably a good choice, however, as the storage sizes are all much larger than the step size. If we were looking into more detail into a given optimisation, or a new set of optimisations, it would be worthwhile re-running the function with a smaller PV size (step) variable. This would also likely find systems with the value for Blackouts closer to the parameter_value. If we were designing a system for implementation, it may also be a good idea to run a final optimisation using a smaller step size for both variables, possibly using the actual capacities of the PV panels and batteries that might be used, to get the most precise answer available.

Incorporating further constraints

Perhaps in addition to wanting to supply electricity at the lowest LCUE, a project developer also has a maximum budget for the lifetime of the project (say $50,000). This could either be a funding constraint or a comparison to some other kind of system, for example using diesel only (rather than solar, storage and the grid as considered here). This time let’s plot the results in terms of the lifetime cost of the system against the availability of electricity, both in terms of time (Blackouts) and also show the availability of energy demanded (using Unmet fraction) for some additional insight:

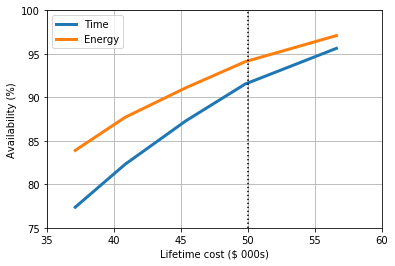

_images/output_21_0_opt.png

In all cases the availability of energy is greater than the availability in terms of time, suggesting that when blackouts occur they are either at times with lower demand or power is available for at least some of those hours when blackouts occur. It also suggests that using Blackouts as the threshold criterion is more strict and will result in a more conservative estimate of reliability.

Here we can see that the maximum budget of $50,000 would correspond to a system with around power available around 92% of the time, and would supply 94% of the energy demanded by the community. This is just an estimate, however, and further optimisations around this point would inform the actual system design and capacities necessary to achieve that performance. Conveniently for us, however, the system found for Parameter value = 0.10 matches these performances quite closely which hints at the next steps for future optimisations: for example, using parameter_values = [0.12, 0.11, 0.10, 0.09, 0.08] to hone in on the best system.

Considering environmental performance

In this case the we designed the systems to meet a minimum level of system performance (Blackouts) at the lowest LCUE, and also added a constraint of the total available budget of the project. Many developers also want to know the environmental impact of the projects, both in terms of the emissions intensity of the power provided and the total GHG emissions.

Let’s first look at the emissions intensity:

Parameter value Emissions intensity (gCO2/kWh)
0 0.25 444.411
1 0.20 437.315
2 0.15 460.682
3 0.10 452.121
4 0.05 487.441

It seems that there is not an obvious linearity here, but there are several factors at play. The systems use approximately the same amount of high-carbon grid electricity, but the higher-reliability systems have a greater share of energy coming from renewable sources which will decrease the average emissions intensity. At higher reliabilities, however, there is a diminishing return on investment for the equipment as more equipment (and hence more embedded emissions) are necessary for the same incremental gains. Let’s compare to the emissions intensity of the grid:

                      0    1          2
18  Grid GHGs (initial)  0.8  kgCO2/kWh
19    Grid GHGs (final)  0.4  kgCO2/kWh

Over the lifetime of the system the average intensity of the grid is around 600 gCO2/kWh, but for all of our systems it is between 430-490 gCO2/kWh, so overall these systems perform quite favourably - especially bearing in mind that some of the 23-28% of their energy comes from the grid (Grid fraction). Diesel-only systems can have emissions intensities around 1000 gCO2/kWh, so these systems seem like a good option. Let’s also consider the total GHG emissions from each source:

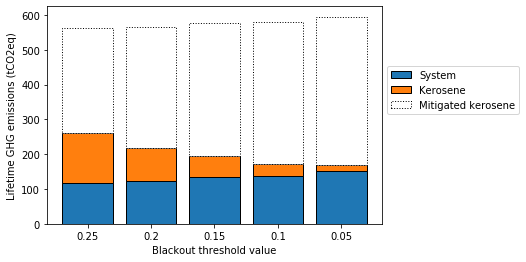

_images/output_27_0_opt.png

The GHGs associated with the system increase as reliability increases, which as discussed earlier is inherent in larger systems with greater equipment requirements. In this case, however, the impact of kerosene usage has a significant effect: kerosene for lighting when electricity is unavailable is very common in our case study location of Bahraich, and by achieving higher levels of reliability our systems can offset larger amounts of kerosene usage in the evenings. Less reliable systems, however, provide less availability in the evening periods and so kerosene usage remains relatively prevalent; this is also captured in the Kerosene displacement variable.

Here we can see that systems with increasing reliability lower total GHG emissions over their lifetimes, but this diminishes between the systems with Parameter value = 0.1 and 0.05. Given the budgetary constraints discussed in the section on incorporating further constraints, let’s assume that the system with Parameter value = 0.1 fits our environmental needs by significantly reducing GHGs from existing kerosene use whilst also staying within an appropriate budget for the project and therefore select this system for deployment.

Returning to system performance

Now that we’ve selected the system with Parameter value = 0.1 as the one to be installed we should investigate its technical performance to make sure that it will meet the needs of the community. Whilst this has already been assessed during the optimisation process, this will allow us to dive deeper into its operation to identify any potentially unexpected results.

To do this we first use a function we mentioned earlier to open the performance of the system from its CSV file:

Note that here we must also specify the folder the file is stored in (Changing parameter optimisation) as the function looks in the Saved optimisations folder by default. Next we can use a function in the Energy_System module to run a simulation for this chosen system, automatically accounting for the equipment upgrades:

Time taken for simulation: 0.23 seconds per year

Time taken for simulation: 0.12 seconds per year

Time taken for simulation: 0.06 seconds per year
Load energy (kWh) Total energy used (kWh) Unmet energy (kWh) Blackouts Renewables energy used (kWh) Storage energy supplied (kWh) Grid energy (kWh) Diesel energy (kWh) Diesel times Diesel fuel usage (l) Storage profile (kWh) Renewables energy supplied (kWh) Hourly storage (kWh) Dumped energy (kWh) Battery health Households Kerosene lamps Kerosene mitigation
0 1.166 1.166 0.0 0.0 0.000 1.166 0.000 0.0 0.0 0.0 -1.166 0.000 30.334 0.000 1.0 100 0.0 75.0
1 0.938 0.938 0.0 0.0 0.000 0.000 0.938 0.0 0.0 0.0 0.000 0.000 30.212 0.000 1.0 100 0.0 103.0
2 0.920 0.968 0.0 0.0 0.000 0.968 0.000 0.0 0.0 0.0 -0.920 0.000 29.123 0.000 1.0 100 0.0 81.0
3 0.377 0.377 0.0 0.0 0.000 0.000 0.377 0.0 0.0 0.0 0.000 0.000 29.007 0.000 1.0 100 0.0 91.0
4 0.402 0.423 0.0 0.0 0.000 0.423 0.000 0.0 0.0 0.0 -0.402 0.000 28.467 0.000 1.0 100 0.0 74.0
5 0.412 0.412 0.0 0.0 0.000 0.000 0.412 0.0 0.0 0.0 0.000 0.000 28.353 0.000 1.0 100 0.0 73.0
6 0.446 0.470 0.0 0.0 0.000 0.470 0.000 0.0 0.0 0.0 -0.446 0.000 27.770 0.000 1.0 100 0.0 70.0
7 1.258 1.320 0.0 0.0 0.081 1.239 0.000 0.0 0.0 0.0 -1.177 0.081 26.421 0.000 1.0 100 0.0 0.0
8 1.479 1.479 0.0 0.0 1.479 0.000 0.000 0.0 0.0 0.0 0.182 1.661 26.487 0.000 1.0 100 0.0 0.0
9 1.300 1.300 0.0 0.0 1.300 0.000 0.000 0.0 0.0 0.0 2.481 3.781 28.739 0.000 1.0 100 0.0 0.0
10 0.726 0.726 0.0 0.0 0.726 0.000 0.000 0.0 0.0 0.0 4.607 5.334 31.499 1.502 1.0 100 0.0 0.0
11 1.668 1.668 0.0 0.0 1.668 0.000 0.000 0.0 0.0 0.0 4.532 6.200 31.499 4.179 1.0 100 0.0 0.0
12 1.105 1.105 0.0 0.0 1.105 0.000 0.000 0.0 0.0 0.0 5.510 6.615 31.499 5.108 1.0 100 0.0 0.0
13 1.100 1.100 0.0 0.0 1.100 0.000 0.000 0.0 0.0 0.0 5.190 6.290 31.499 4.805 1.0 100 0.0 0.0
14 1.947 1.947 0.0 0.0 1.947 0.000 0.000 0.0 0.0 0.0 3.413 5.361 31.499 3.117 1.0 100 0.0 0.0
15 2.226 2.226 0.0 0.0 2.226 0.000 0.000 0.0 0.0 0.0 1.537 3.763 31.499 1.334 1.0 100 0.0 0.0
16 1.479 1.479 0.0 0.0 1.479 0.000 0.000 0.0 0.0 0.0 0.254 1.733 31.499 0.115 1.0 100 0.0 0.0
17 3.626 3.626 0.0 0.0 0.153 0.000 3.473 0.0 0.0 0.0 0.000 0.153 31.373 0.000 1.0 100 0.0 122.0
18 2.001 2.106 0.0 0.0 0.000 2.106 0.000 0.0 0.0 0.0 -2.001 0.000 29.141 0.000 1.0 100 0.0 333.0
19 4.447 4.681 0.0 0.0 0.000 4.681 0.000 0.0 0.0 0.0 -4.447 0.000 24.343 0.000 1.0 100 0.0 338.0
20 1.961 2.064 0.0 0.0 0.000 2.064 0.000 0.0 0.0 0.0 -1.961 0.000 22.181 0.000 1.0 100 0.0 336.0
21 1.576 1.576 0.0 0.0 0.000 0.000 1.576 0.0 0.0 0.0 0.000 0.000 22.093 0.000 1.0 100 0.0 277.0
22 2.226 2.343 0.0 0.0 0.000 2.343 0.000 0.0 0.0 0.0 -2.226 0.000 19.661 0.000 1.0 100 0.0 132.0
23 2.038 2.145 0.0 0.0 0.000 2.145 0.000 0.0 0.0 0.0 -2.038 0.000 17.437 0.000 1.0 100 0.0 108.0

Here we have once again displayed the first day of data from this simulation output, similarly to the section on simulation outputs and notice that the output of Energy_System().lifetime_simulation(...) gives a single output of the system performance, rather than the additional second output describing the makeup of that system (as we already know it from the input we used).

As an aside, it is also possible to perform the reverse process that we have just used: we can generate the technical, financial and environmental outputs of a given simulation using the function Optimisation().system_appraisal(chosen_system_simulation). This function takes the (two-component) variable chosen_system_simulation as an input, and returns the same format of appraisal results as is generated by the standard optimisation processes. This could be useful, for example, when assessing the performance of a specific case study system which was not generated through the optimisation process.

Let’s look at the energy use on an average day for each of the three iteration periods, plotted at the same scale:

_images/output_33_0_opt.png

We can observe here the growing energy generation and usage across the three iteration periods and some minor variations in the relative usage of each source of power at different points during the day, but in general the performance seems quite similar across the three iteration periods over the lifetime of the system. If we had further issues to consider, for example if the load profile changed in shape over time as well as increasing, we might need to investigate the different iteration periods in more detail.

Now let’s look at the availability of energy, in terms of the average proportion of blackouts per day, over the lifetime of the system:

_images/output_35_0_opt.png

To remove some of the inherent variability between days we present the data in terms of a 30-day rolling average. As we can see, the availability of power varies quite significantly over the lifetime and each iteration period: as the load grows, the ability of the system to maintain the desired threshold decreases and so blackouts increase around halfway through each iteration period. There is also a seasonal effect, where blackouts occur more frequently in the winter months. Let’s look at the average blackouts for each year of the lifetime:

Year | Mean | Standard deviation
Year 1: 0.01 +/- 0.11
Year 2: 0.04 +/- 0.19
Year 3: 0.07 +/- 0.26
Year 4: 0.14 +/- 0.35
Year 5: 0.01 +/- 0.12
Year 6: 0.06 +/- 0.24
Year 7: 0.11 +/- 0.32
Year 8: 0.17 +/- 0.37
Year 9: 0.05 +/- 0.21
Year 10: 0.07 +/- 0.26
Year 11: 0.12 +/- 0.32
Year 12: 0.17 +/- 0.37
Lifetime average: 0.08 +/- 0.28

The first two years in each iteration period (1-2, 5-6, 9-10) perform better than expected, but the final years (4, 8, 12) all have far more blackouts than our threshold value (0.10) or the lifetime average. These later years also have larger standard deviations, which means that some days have more variable performances, also visible in the figure above.

This could pose a problem for system operators: although customers will receive an adequate service on average, during the winter months or the later years they might not pay their monthly bills (for example) if their service has not met the levels promised to them. This will affect the financial returns of the project, as well as potentially influence community perception of the system.

If these periods of reduced availability will be an issue we have a few options to improve the system design. The first would be to re-optimise the system using a more restrictive threshold criterion: this will likely lower both the mean for each iteration period and the lifetime average, but the same changing profile will probably still be present (albeit exceeding the initial threshold of Blackouts = 0.10 less frequently). Another option would be to shorten the lifetime period, allowing the system to be resized more frequently to better account for the growing load profile and have a more consistent incidence of blackouts. Finally in practice it may be pragmatic to install the system as designed here but monitor its performance: if the load profile grows over time as expected the system could be revisited earlier than expected to maintain the desired performance, or if not then new equipment could be installed later.

Practical considerations

CLOVER is designed for users to model community electricity systems, simulate their performance, and identify optimum configurations based on the inputs they choose. The simulation and optimisation functions, and CLOVER in general, will provide results which can inform system design for practical deployment but should always be treated with appropriate caution. The confidence you have in your input data, for example, can be used as a good judge of the confidence you have in the results of using CLOVER.

This is not to say that all of the modelling is purely theoretical: CLOVER should be used as a tool to help inform research or practical system deployment in the context of many other activities such as community engagement, political priorities, business model development and technical equipment specifications. These practical considerations are sometimes impossible to quantify and so should be dealt with separately to ensure they are properly accounted for as part of a project, and should inform (and be informed by) modelling in CLOVER wherever possible.

The greatest value that CLOVER can bring to a project is its ability to (relatively) quickly and easily explore many different scenarios and provide results on the design and performance of systems that can be explored in detail. Questions around providing different levels of service to a community, using different types of energy technologies, and under different load growth scenarios and grid availabilities can all be answered using CLOVER, with the results considering more than just the cost of electricity but many other performance, financial and environmental metrics to best understand the implications of a given system.

Once CLOVER has been used to identify a system which would be a good candidate for deployment then the considerations around the equipment to be installed, the topography of the distribution network, the customers to be connected, the payment structures, the overall business model and many other practical points can be brought in to interrogate the appropriateness of the proposed system. These are beyond the scope and capabilities of CLOVER and will rely on the expertise of the user or their team to best identify how to implement a system which can provide reliable, affordable and sustainable electricity to the communities they aim to serve.
